2015-09-04 - 19936 - Spec - Vendor Capacity Planning #ABAPVendorCapacity #MMPPSupport

SPECIFICATIONS

19936 - Spec - Vendor Capacity Planning


Purpose


Implementation of Vendor Capacity Planning.

Admin Info


Purpose
Implementation of Vendor Capacity Planning
Requested By
Jeffrey Mau/ Babu Lankipalli
Spec Created By
Laxman
Spec Created Date
09/07/2015
Spec QA by
Laxman
Objects

Document Status
Complete

Estimates


Sl.No
Activity
Estimation in Hours
1
Research
32
2
Documentation
24
3
Development/ Config
268
4
Unit test in DEV
32
5
Unit test in QUA
24
6
Other activity


TOTAL
380


BluePrint
Realization
DEV
(incl. unit Test)
Int. Testing
Q
Cutover
/Go-Live
Total
Calendar Days -->
7
25
3
15
50

Hours

MM Functional
48
60
24
60
192
ABAP
8
140

40
188
TOTAL
56
200
24
100
380
References

Prior Tickets

[Provide links of prior associated Spec / Break Fix BOSS document(s)]
Specification

Documents

[Attach any document(s) received for the requirement(s)]

Spec Changes


[List the changes made to program after the approval of the original requirement along with the Date on which the change request was received and the name of the initiator]

Sl.
Change Details
Requested By
Requested On
Notes if any





Functional Requirement


Purpose/WHY:

[Explain the purpose of the project and the reason why this requirement has come]
By implementing the vendor capacity planning will get the information of available vendor capacity, so that we can react to market changes without having to build up the high warehouse stocks.

In Scope:

[List the activities to be included in scope]

- Implementation of standard vendor capacity planning (Including implementation of all the relevant OSS notes)
- Features/ Functions

- Configuration of vendor capacity planning
- Master data maintenance
- Creation/ change of data loading programs
- Assuming that we can go maximum up to 2 level/ node capacity structure.

Out of Scope:

[Out of scope activities]
AFS Source allocation - Simulation reports and Lists

Solution Summary


[Discuss this section with Requester and get approval prior to beginning work]

To implement the vendor capacity planning these are activities to be performed.

Vendor Cap.jpg

Evaluation of Standard Vendor capacity Planning:

Vendor capacity by Vendor:

Cap by Vendor11.jpg

Cap by Vendor12.jpg

Capacity by Period:


Cap by Period11.jpg

Cap by Period12.jpg

Capacity By Node:

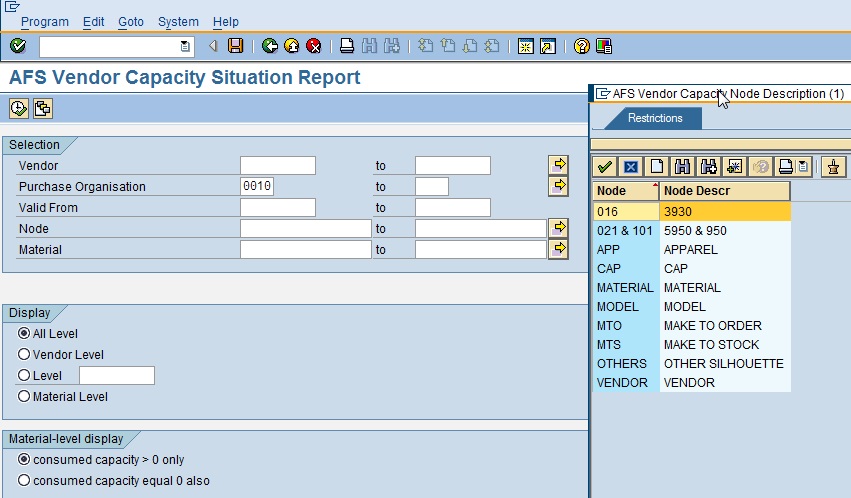

Cap by Node11.jpg

Cap by Node12.jpg

Capacity by Material:

Cap by Material11.jpg

Cap by Material12.jpg

Mass Data change11.jpg

Mass data change12.jpg

Test Plan

[List test scenarios/cases to be executed here]
Test ID
Test Scenario
Expected Results
MM001
Maintain the capacity for one of the vendor and create standard NB POs in that period
Value of consumed capacity should be correct
MM002
Maintain the capacity for one of the vendor and create Z3NB POs in that period
Value of consumed capacity should be correct
MM003
Maintain the capacity for one of the vendor and create PTO POs in that period
Value of consumed capacity should be correct
MM004
Delete the purchase order and check vendor capacity
Consumed capacity value should be resumed in the report
Solution Details

[Provide complete technical details for configuration or programming here]

Implement the vendor capacity planning after getting approval from New Era.
1. Implemented Exit - 'EXIT_SAPMM06E_012' to assign materials to Vendor Capacity Planning while saving Purchase Order.
2. Created a program ZMM_VCP_ASSIGN to assign materials to Vendor Capacity Planning for Initial Load from the Flat File
VCP - Format.txt

Issues


[List Issues / Bugs identified in configuration or development]

Issues observed during testing in Quality.
1. Observed inconsistencies in the vendor capacity simulation report.
2. Observed occasionally 'Book with new period POPUP during creation of purchase order.
3. During testing observed that number range is very less (0-999999).

After go-live observed these issues.
1. Observed frequently 'book with new period POPUP during creation purchase order.
2. Some times purchase orders are saving very slow and going for dump.
3. Correction report /AFS/J_3AMCAC taking more time like more than one day.
4. Observed inconsistencies in the vendor capacity simulation report.
5. Inconsistent data in a particular period (7th Period)

For all the above issues are escalated to SAP, Since all these issues are due to bug in the VCP program.

1. SAP has released the OSS note 2290525, 2299274 to resolve the 'book with new period POPUP' issue during creation of purchase order.
2. SAP has released the OSS note 2300157 to resolve the inconsistencies in the vendor capacity simulation report.
3. SAP has released the OSS note 2298945 to improve the performance of vendor capacity correction report.
4. SAP has released the OSS note 2308383 to increase the number range of vendor capacity.
5. SAP has released the OSS note 2317140 to remove the inconsistencies in a particular period.
6. SAP has released the OSS note 2298087 to remove the inconsistencies in when pre-packs are used.
7. SAP has released the OSS note 1289378 & 2286052 to correct the correction report /AFS/J_3AMCAC.
8. SAP has released the OSS note 2309648 to determine correct capacity period.
9. SAP has released the OSS note 2281231 to resolve the update termination issue during change of PO.
.
Go-Live Schedule (06/25/2016)

EXIT_SAPMM06E_012
Steps
Process
Date
Tent Time
IST
EST
Responsible
Step1
Vendor capacity data extraction
6/24/2016



Laxman
Step6
Extract materials of PO till date
6/24/2016



Babu
Step2
User exit deactivation
6/25/2016
5mins
11:00
01:30
Laxman
Step3
Data deletion
6/25/2016
10mins
11:05
01:35
Laxman
Step4
Move all TPs and OSS notes
6/25/2016
1hr
11:15
01:45
Laxman
Step5
Maintain vendor capacities
6/25/2016
30mins
12:15
02:45
Laxman
Step7
Assign materials one vendor
6/25/2016
15mins
12:45
03:15
Laxman
Lunch Break - 30 Mins
Step8
Run correction reports one vendor
6/25/2016
2hr
01:30
04:00
Laxman
Step9
Convert req into PO
6/25/2016
15mins
03:30
06:00
Babu
Step10
Assign materials to all other vendors
6/25/2016
2hr
03:45
06:15
Laxman




05:45
08:15

Step11
Run correction reports to all vendors
6/25/2016
Report will be scheduled one after one


Babu
